03 FEVRIER : MISE EN PLACE DE LA PASSERELLE QUI RELIERA LA RUE DU RUISSEAU ET LE SENTIER QUI LONGE LE NACEY EN DIRECTION DU " PATIS" .

26 AVRIL : REMPLACEMENT DES 2 POMPES DU PUIT DE CAPTAGE DES EAUX USEES AU LOTISSEMENT LE "PATIS" PAR M.G.E.

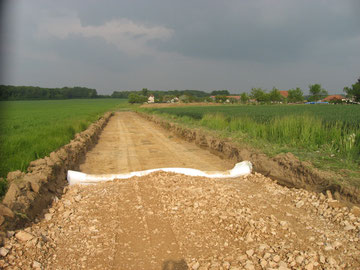

27 AVRIL : COMMENCEMENT DES CHEMINS FORESTIERS ET AGRICOLES PAR ROUX T.P.S.

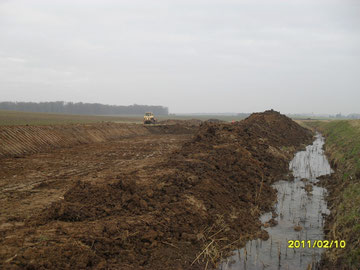

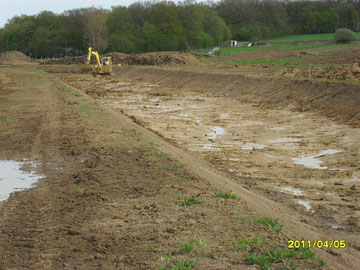

10 FEVRIER : L' ENTREPRISE S.J.E. COMMENCE LES TRAVAUX DE RENATURATION DU NACEY.

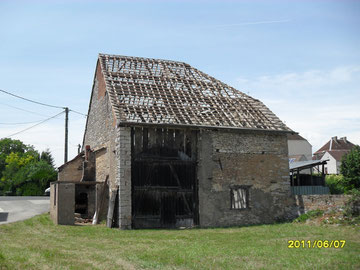

26 MAI : DEMONTAGE DES TUILES DE LA GRANGE RUE DU CHATEAU.

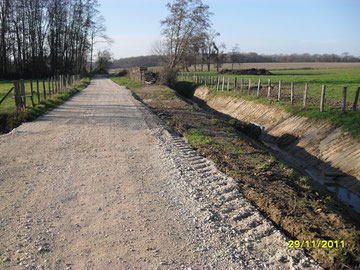

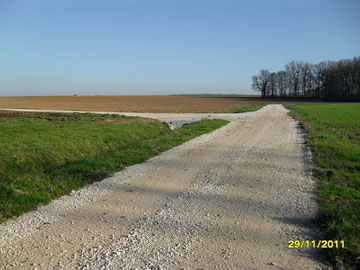

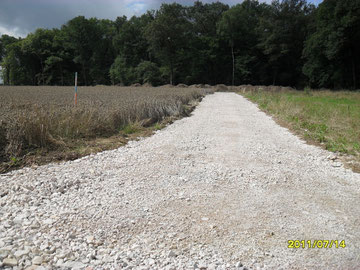

17 JUIN : TRAVAUX DES CHEMINS.

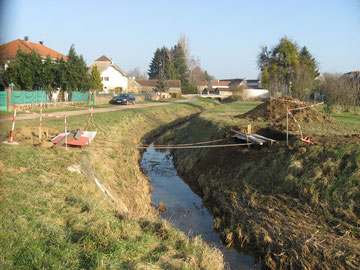

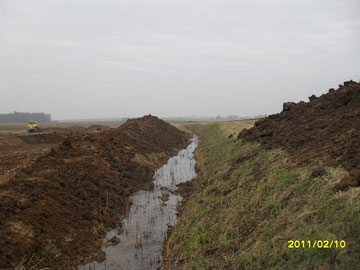

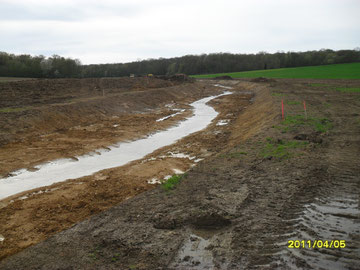

05 AVRIL : S.J.E. EST EN TRAIN DE CREUSER LE LIT MINEUR DU NACEY.
19 JUILLET : DEMONTAGE DU MONUMENT AUX MORTS .

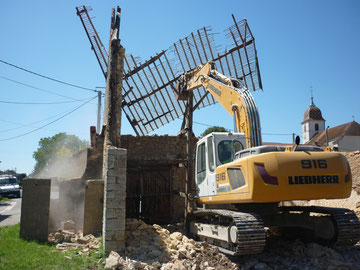

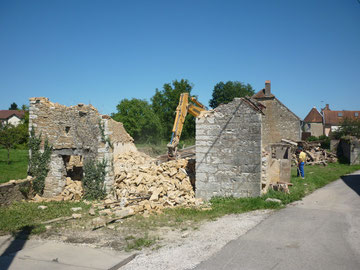

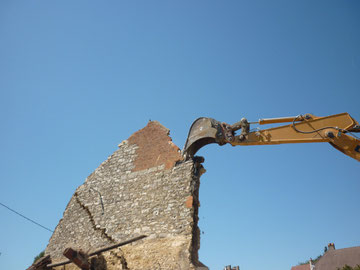

01 AOUT : DESTRUCTION DE LA GRANGE PAR MR BELLENEY.

24 AOUT : FAUCHAGE DU NACEY PAR MR MARTIN.
31 AOUT : SUITE A UN ORAGE , MR MILLERET DE CHARCENNE REMPLACE 2
LAMPADAIRES RUE DU CHATEAU.
05 SEPTEMBRE : RETOUR DE ROUX T.P.S. POUR LA FIN DES TRAVAUX.
RENATURATION DU NACEY (SUITE) .
26 SEPTEMBRE : REMPLACEMENT DE CANIVEAUX DEVANT LE 17 DE LA RUE
PRINCIPALE PAR LES EMPLOYES COMMUNAUX.
27 SEPTEMBRE : VIDANGE DE LA GRANDE FONTAINE POUR NETTOYAGE ET
RECHERCHE DE LA FUITE AU NIVEAU DU " CHATEAU D ' EAU " PAR LES EMPLOYES COMMUNAUX .

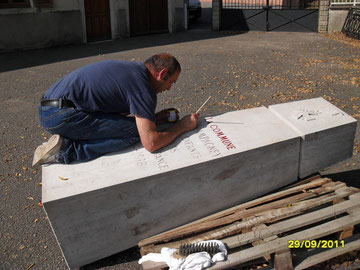

29 SEPTEMBRE : MISE EN PEINTURE DES LETTRES GRAVEES SUR LE MONUMENT
AUX MORTS PAR PASCAL ET OLIVIER.

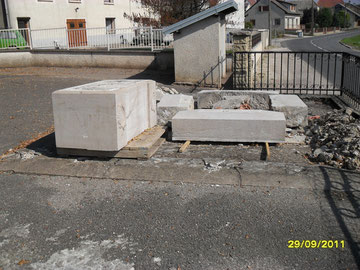

29 SEPTEMBRE: DECAISSEMENT DE L'EMPLACEMENT DES FONDATIONS DU
MONUMENT AUX MORTS PAR MR VUILLEQUEZ.

04 OCTOBRE:COULAGE DES FONDATIONS DU MONUMENT PAR MR VUILLEQUEZ A
L'AIDE D'UNE TOUPIE DE DIJON BETON.
06 OCTOBRE:FIN DE LA MISE EN PEINTURE DES LETTRES DU MONUMENT PAR
PASCAL OLIVIER ET NOEL.

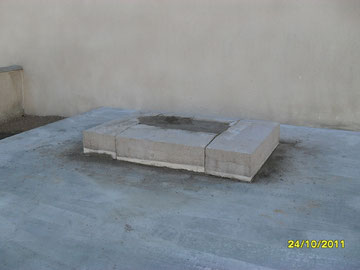

12 OCTOBRE: COULAGE DE LA DALLE DU MONUMENT AUX MORTS ,SUR LAQUELLE
LES PREMIERES PIERRES SERONT POSEES.
20 OCTOBRE:TRANSFERT DES PIERRES DU MONUMENT VERS SON NOUVEL EMPLACEMENT PAR PIERRE ,OLIVIER, NOEL ET GILLES.
22 OCTOBRE:MISE EN PLACE DES 4 PIERRES DE L'EMBASE DU MONUMENT.

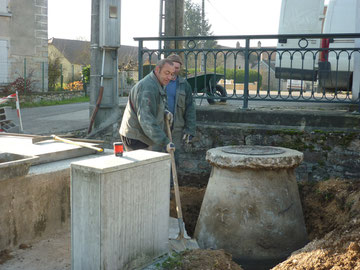

26 OCTOBRE:COFFRAGE DE LA REHAUSSE DU PUITS DE CAPTAGE DES EAUX USEES
DE LA RUE PRINCIPALE PAR LES EMPLOYES COMMUNAUX.
26 OCTOBRE:INSTALLATION DU MONUMENT AUX MORTS PRES DE LA MAIRIE PAR
PIERRE,CHRISTIAN,NOEL,OLIVIER ET GILLES.
27 OCTOBRE:COULAGE DE LA REHAUSSE DU PUITS PAR JEAN LUC,PIERRE,NOEL ET GILLES.
28 OCTOBRE:JOINTOIEMENT DES PIERRES DU MONUMENT PAR JEAN LUC.
10 NOVEMBRE:POSE DU MAT AUX COULEURS PRES DU MONUMENT.
17 NOVEMBRE:ENTRETIEN DE LA MACHINERIE DU CLOCHER PAR ENTREPRISE
BODET.
28 NOVEMBRE:REHAUSSE D'UN REGARD A PROXIMITE DU PUITS DE CAPTAGE DES EAUX PAR LES EMPLOYES COMMUNAUX.

29 NOVEMBRE: REALISATION D'UN BI-COUCHE DANS LE LOTISSEMENT DE LA
TUILERIE.

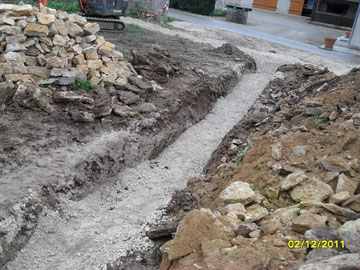

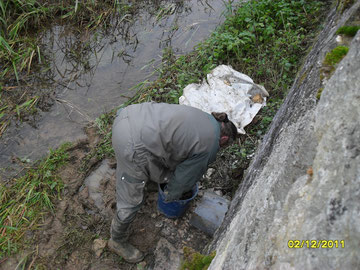

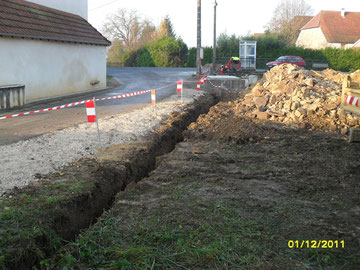

02 DECEMBRE: POUR LE PASSAGE DES GAINES D'EAU POTABLE ET D'ELECTRICITE ,
STEPHANE DUREY A EFFECTUE DE NOMBREUSES TRANCHEES A COTE DU PUITS .
DONT UNE , POUR EVACUER L'EAU PROVENANT D'UNE SOURCE.
